Why Rotating Equipment TAR Success Is Won 18 Months Before Shutdown
In LNG facilities, turnarounds are not routine maintenance events. They are high-stakes operational resets.
When a liquefaction train shuts down, production stops entirely. Revenue pauses. Contractor density increases. Risk multiplies. Every additional day of outage carries multi-million-dollar exposure.
Across LNG conferences and shutdown summits, one message consistently dominates:
Planning maturity and scope discipline are the primary control mechanisms of turnaround performance.
Culture, materials readiness, governance gates, contractor competence, and risk management are critical — but they function as supporting systems. Without disciplined scope definition and freeze maturity, those systems cannot stabilize execution.
Independent Project Analysis (IPA, 2018) repeatedly shows that projects with strong Front-End Loading (FEL) dramatically outperform poorly defined projects in cost and schedule performance.
In LNG rotating equipment TARs, the difference between success and overrun is rarely mechanical capability.
It is scope control.
1. The LNG Reality: Why Scope Discipline Is Non-Negotiable
An LNG turnaround concentrates:
Full-train production loss
Cryogenic system depressurization
Gas turbine major inspections
Large centrifugal compressor case openings
Dry gas seal replacements
Gearbox inspections
Statutory pressure vessel inspections
Control system upgrades
Unlike smaller facilities, LNG trains cannot partially operate during major TARs. Scope growth directly extends revenue loss.
Merrow (2011) demonstrated that late scope changes are among the strongest predictors of project underperformance. In LNG environments, this is amplified because:
Critical path activities are tightly interdependent
OEM specialists have limited global availability
Heavy lift windows are pre-engineered
Long-lead rotating components have global supply chains
Scope uncertainty entering execution is financially dangerous.
2. Front-End Loading (FEL) in LNG Rotating Equipment TARs

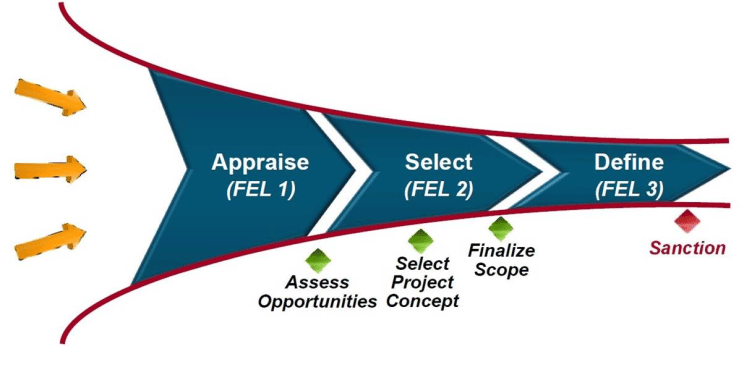

Figure 1. Front-End Loading concept showing influence over cost, highest during early planning phases, and decreasing during execution. Concept aligned with IPA (2018) and PMI (2021).
Front-End Loading in LNG TARs means:
Major inspection philosophies defined 18–24 months early
OEM scope agreed well before procurement lock
Replace-vs-inspect strategy pre-decided
Long-lead bearings and seals secured
Risk workshops completed
Budget accuracy tightened before execution
IPA (2018) research shows that higher FEL maturity strongly correlates with lower cost growth and schedule deviation.
For rotating equipment, FEL includes:
Validated vibration trend analysis
Oil analysis history review
Trip log evaluation
Thrust bearing loading trend review
Historical rub or surge history assessment
When FEL is strong, the scope is risk-justified and bounded. When FEL is weak, discovery work expands unpredictably.
Critically, this scope discipline directly influences plant KPIs:
Improved MTBF
Reduced forced outage probability
Increased train availability
Reduced lost LNG production days
The line of sight is clear: disciplined scope → stable TAR → preserved availability.
3. Risk-Based Scope Selection for Rotating Equipment

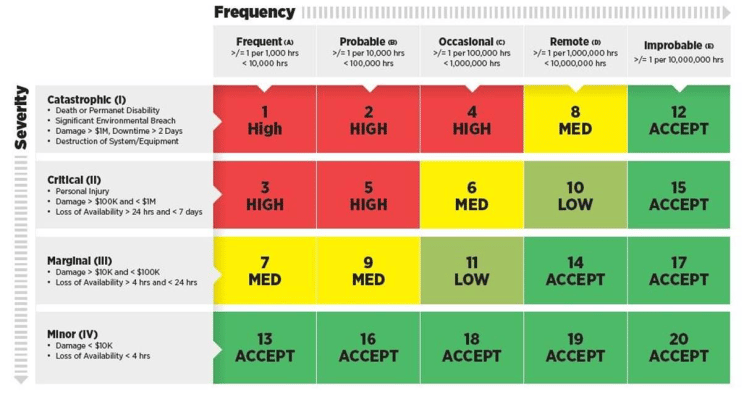

Figure 2. Example probability–consequence risk matrix used in Risk-Based Inspection and TAR scoping. Concept aligned with API RP 580 (2016) and ISO 31000 (2018).
In LNG TARs, not all rotating equipment work belongs in the shutdown.
Risk-based scoping evaluates:
Probability of failure before next TAR
Consequence of failure (full train trip vs localized upset)
Ability to detect degradation online
System redundancy
This approach assumes credible condition monitoring data — validated vibration analysis, reliable oil diagnostics, and correctly interpreted trip history. Poor data quality or flawed analysis undermines the entire risk-based methodology.
API RP 580 (2016) emphasizes prioritization based on probability and consequence, not convenience.
The disciplined question becomes:
Does this work require shutdown isolation, or can risk be managed until the next window?
Without a structured risk methodology, scope becomes a backlog-clearing exercise.
4. The Scope Creep Spiral in LNG TARs
Scope creep in LNG often hides behind reasonable engineering logic.
Common patterns:
“Since the compressor is open, replace all bearings.”
“Upgrade the coupling design while we’re there.”
“Let’s modify the seal system now.”
Individually rational. Collectively destabilizing.
For example:
Adding a non-critical coupling upgrade during a major compressor overhaul may introduce:
24–36 additional labor hours
Additional NDT
Re-machining contingency
Revised alignment checks
If that addition extends rotor reassembly by even 8 hours, and that work lies on the critical path, the downstream impact can easily push restart by a full day.
In a large LNG train producing 3–5 million tonnes per annum, a single day of delay can represent US$1–3 million in deferred revenue, depending on contract structure and market conditions.
This is how “small” scope additions escalate financially.
Merrow (2011) links late changes directly to schedule and cost underperformance.
5. Scope Freeze and Governance
Figure 3. Stage-gate and Management of Change frameworks supporting TAR scope discipline. Aligned with CCPS (2014) and PMI (2021).
High-performing LNG sites implement:
Preliminary scope freeze (~12 months prior)
Technical scope freeze (~6 months prior)
Final freeze (~3–4 months prior)
Strict MOC for additions
After the final freeze, additions must be:
Safety critical
Regulatory mandatory
High likelihood of failure before next TAR
CCPS (2014) emphasizes structured change control to reduce operational risk during high-density maintenance.
Freeze discipline protects critical path stability.
6. Work Pack Engineering: Planning Made Visible
Work pack quality determines execution predictability.
High-quality LNG rotating equipment packs include:
Detailed disassembly steps
Rotor lift plans
Seal handling procedures
Torque specifications
Alignment methodology
Inspection hold points
Contingency for unexpected findings
Incomplete packs create field improvisation.
Improvisation erodes contingency.
Contingency erosion increases schedule pressure.
Schedule pressure increases safety exposure.
Planning depth is risk control.
7. Long-Lead Material Strategy
Rotating equipment TARs depend on:
Bearings
Dry gas seals
Thrust pads
Specialty gaskets
Control system components
Lead times can exceed 9–12 months.
IPA (2018) links supply chain immaturity to project cost growth.
If a thrust bearing ordered late arrives two weeks after planned reassembly, the resulting delay dwarfs the early engineering effort cost.
Material strategy is the scope strategy.
8. The Cost-of-Change Curve in LNG TARs

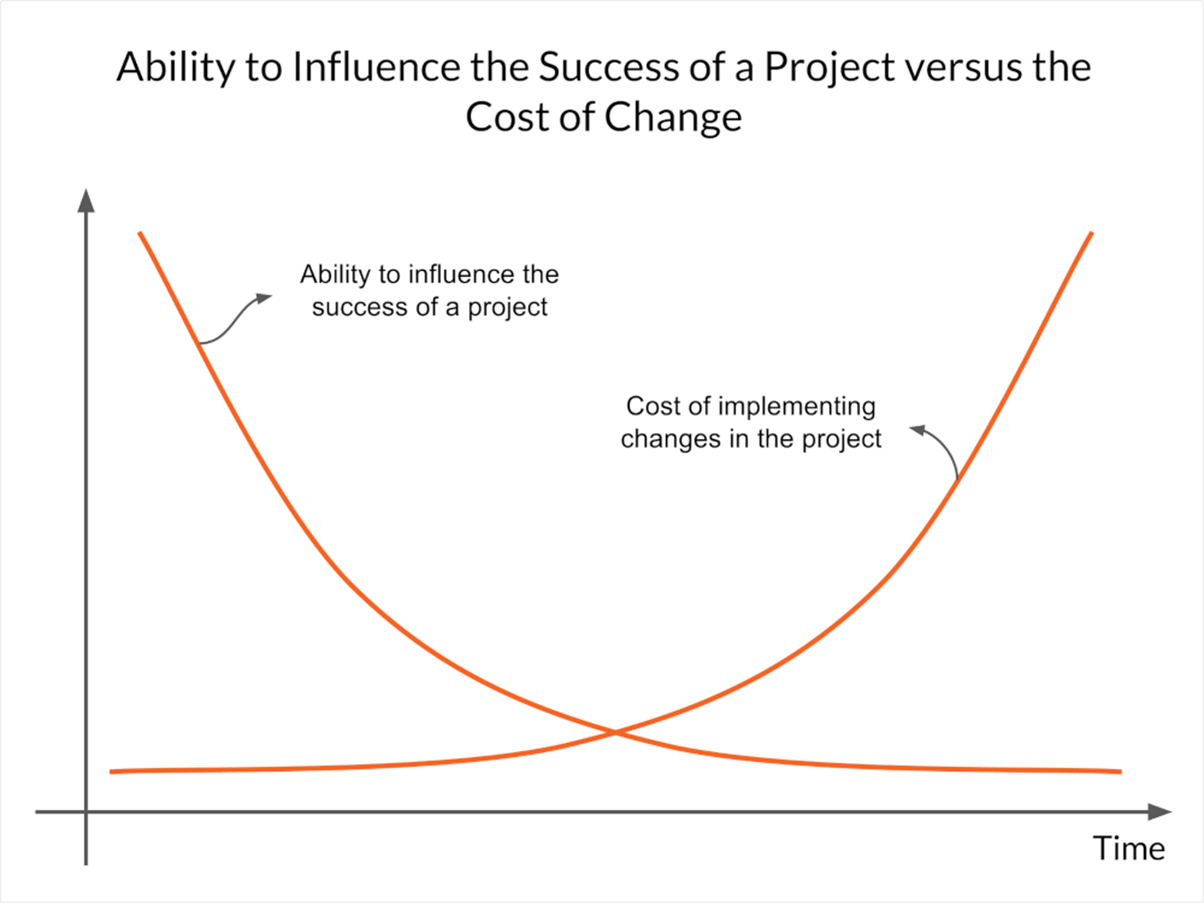

Figure 4. Conceptual cost-of-change curve illustrating exponential cost growth of late scope decisions. Aligned with Merrow (2011) and IPA (2018).
The widely cited cost-of-change curve is an illustrative order-of-magnitude concept, not a measured ratio, but it reflects consistent industry experience:
$1 decision during early planning
$10 during detailed engineering
$100 during execution
$1000 during restart delay
In LNG, the financial multiplier is real.
The shutdown window is the most expensive time to solve unresolved technical questions.
9. Cultural Maturity and Scope Discipline
High-performing LNG organizations demonstrate:
Early technical decision-making
Data-driven risk ranking
Strict freeze enforcement
Executive sponsorship
Clear rejection of non-critical additions
Reactive organizations demonstrate:
Late additions
Decision avoidance
Scope drift
Contractor blame
Turnaround performance reflects organizational discipline more than mechanical complexity.
Conclusion: Control Begins with Scope
In LNG rotating equipment TARs, planning maturity and scope discipline are the primary control mechanisms.
Everything else — materials readiness, culture, governance, contractor competence — reinforces that control system.
Successful TARs require:
Risk-based scope selection
Credible condition monitoring inputs
Early technical decisions
Material readiness
Strict freeze enforcement
Mature MOC governance
Industry research is consistent:
Poor scope definition leads to overruns. Late changes multiply the cost. Weak governance destabilizes execution.
In LNG turnarounds, planning is not preparation.
Planning is control.
And control begins with scope discipline 18 months before the first flange is broken.
References:
API (2016) API RP 580: Risk-Based Inspection. American Petroleum Institute. CCPS (2014) Guidelines for Managing Process Safety Risks During Organizational Change. Independent Project Analysis (2018) Front-End Loading and Project Performance Research Findings. ISO (2018) ISO 31000: Risk Management – Guidelines. Merrow, E. (2011) Industrial Megaprojects. Wiley. PMI (2021) PMBOK Guide, 7th ed.
